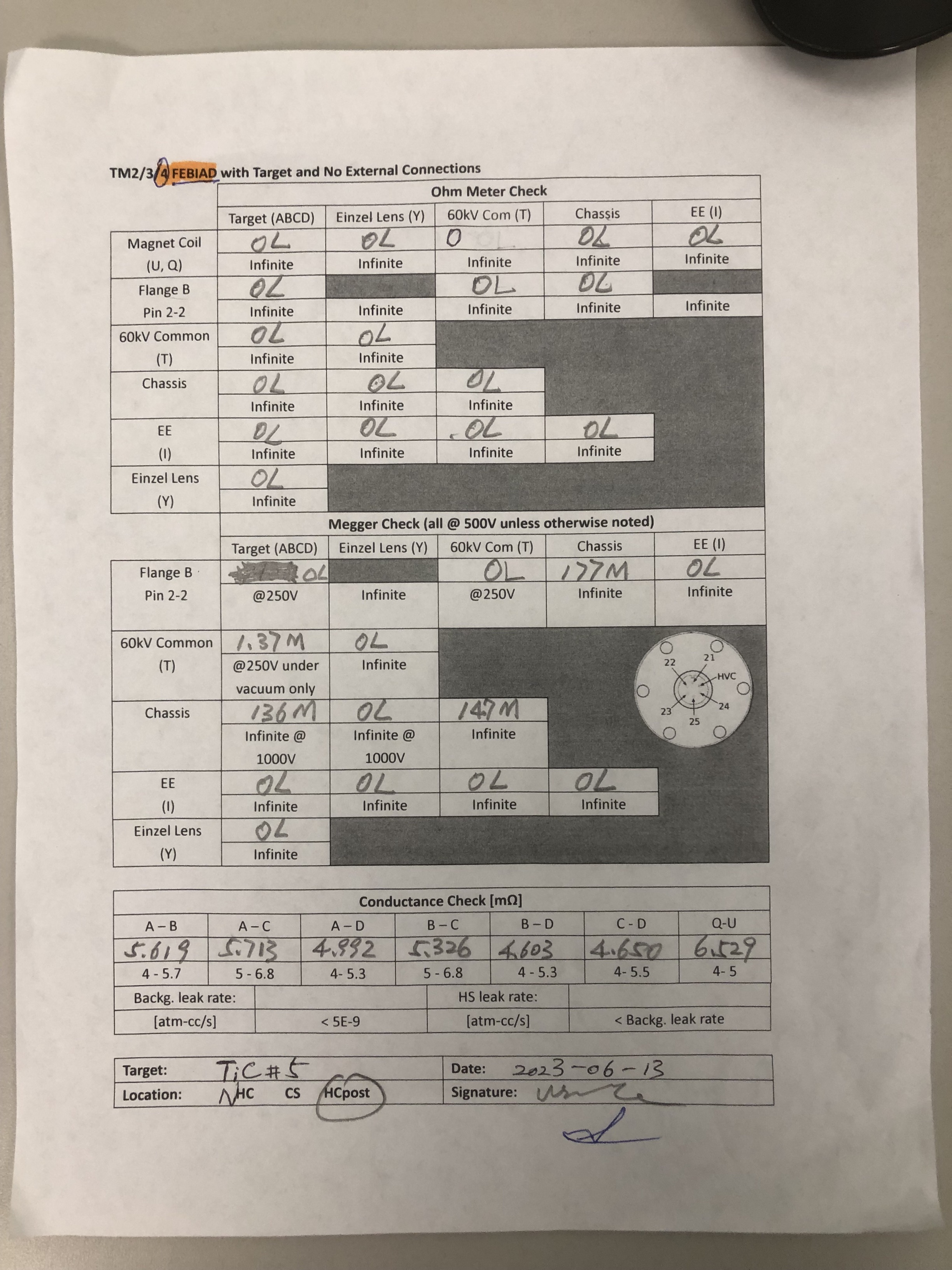

  2491   Tuesday, October 03, 2023, 14:28 Frank SongSouth Hot-CellStandard OperationTM2Nb#11electrical check

 An electric checked right after TM2 was moved from ITW.

Attachment 1: TM2_with_spent_target_Nb#11_electrical_check_right_after_moving_from_ITW_to_SHC.pdf
TM2_with_spent_target_Nb#11_electrical_check_right_after_moving_from_ITW_to_SHC.pdf
  2355   Wednesday, August 10, 2022, 08:10 Frank SongNorth Hot-CellStandard OperationTM4Sic#44electrical and leak check

 TM4 with Sic#44 installed and had an electrical / leak check at NHC.

Attachment 1: TM4_with_Sic#44_eletrical_and_leak_check.jpg
  2480   Monday, August 28, 2023, 12:16 Frank SongNorth Hot-CellRepairTM2Nb#11electric/leak check

 TM2 with new target Nb#11 has been E/L checked sitting on NHC.

Attachment 1: TM2_with_Nb#11_electical_and_leak_check_in_NHC_2023-08-28.pdf
TM2_with_Nb#11_electical_and_leak_check_in_NHC_2023-08-28.pdf TM2_with_Nb#11_electical_and_leak_check_in_NHC_2023-08-28.pdf
  2392   Wednesday, November 23, 2022, 11:27 Frank SongNorth Hot-CellStandard OperationTM4UCx#41electric and leak check after new target installed

 an electric check and leak check done on NHC, TM4 with new target UCx#41 is ready moving to TCS.

Attachment 1: TM4_with_UCx#41_electric_and_leak_check_on_NHC.png
  2381   Tuesday, November 01, 2022, 12:37 Frank SongITWStandard OperationTM2UCx#39disconnection

 TM2 with spent target UCx#39 was disconnected in ITW then moved to NHC.

Attachment 1: TM2_with_UCx39_disconnection_in_ITW.png
  791   Tuesday, November 18, 2014, 11:14 David WangSouth Hot-CellStandard Operation UCx11crane down UCx 11 target into SHC from TH

I craned down UCx11 target from TH into SHC. Chad was in SHC service area watching on it. The source tray moving jig was installed on the crane for this moving.

  2329   Thursday, June 09, 2022, 09:47 Matthew GareauSouth Hot-CellRepairTM2SiC#42containment box repair, Einzle lens, multi pin

On June 2 2022, while attempting to install target SiC#42 a gasket fell off the water line. I attempted to remove the target to have the gasket reattached, however the multi pin connector guide pin was loose and was preventing the target from being removed. During the attempt to remove the target it was noticed that an electrical cable in the back of the module had become loose and was dangling. The target was then secured to the module, and then the module was moved to the SHC to complete the job/repairs.

June 3 2022, containment box was removed, Einzle Lens cable reattached and tested, and the multi pin guide pin was retightened.

On June 6 2022, the containment box was damaged while lifting the containment box back onto the module.

The left rear corner of the box caught on the module and the corner weld snapped and folded the corner down about 90 degrees.

With help from Chad, we were able to restraighten the corner with a C-clamp, enabling the box to be reattached to the module.

However the 2 bolts that were on the corner that attach to the module were not able to be aligned and were not used.

The target was reattached to the module, and to save time was brought directly to ITW, skipping the conditioning station.

  812   Thursday, December 04, 2014, 16:37 David WangConditioning StationDevelopmentTM2 connected TM2 and CS vacuum system .

I connected TM2 and CS vacuum system. All vacuum pumps on TM2 and CS are started .The pumping down is good so .far

  79   Monday, April 02, 2012, 08:17 David WangConditioning StationDevelopment  conditioning station IMC pump down.

I pumped down conditioning station IMC today. The inside bellow pressure is -20 psi on the gauge.Visually checked the bellow before and after pump.The bellow is in retracted condition now.

  83   Thursday, April 12, 2012, 14:40 David WangConditioning StationDevelopmentTM1 conditioning staion and TM1 is under TP1 and TP2 pumping now.

TM1 moved to conditioning station to today. After moving, I connected the vacuum system which include all gauges ,vacuum lines , controllers,and fans.I started roughing the station through two turbo pumps(on TM1) . After 2 hours roughing, the station vacuum went to 100 mtorr. I started TP1 and TP2 on TM1 and turned on 3 gauges (png1 on service cap, ig1 on service cap ,and png4 on emittance box) . All  turbo pumps and high vacuum gauges work fine .The pumping down of the station is smooth so far. With only 1 hour turbo pump on all three gauges readings are at low -5 torr range. The fans for cooling the turpump are also turned on. Everything is fine.

  121   Friday, June 08, 2012, 11:07 David WangConditioning StationStandard OperationTM1Ta38conditioning staion and TM1 is under TP1 and TP2 pumping now.

I connected vacuum system to TM1 and conditioning station and started two turbo pumps yesterday. The pumping an d vacuum readings  are verg good so far(all below 5xE-6 torr). Helium pressure test on heat shield circuit will be fulfilled next week.

  95   Thursday, April 26, 2012, 09:23 David WangITERepairTM4 changed flow wheel on ITE TM4 contaiment box water circuit

The the magnetic field on ITE TM4 flow wheel  was gone yesterday.So there is no water signal on this circuit. The water flow is fine ,and the wheel is rotating. I removed 1 shielding block on ITE and replaced the old wheel with a new one.Now the containment box water signal is normal.The problem is fixed.The shielding block is back.

  2730   Wednesday, December 04, 2024, 09:00 David WangFacilitiesStandard OperationTM2 all water lines on TM2 have been purged.

all water lines on TM2 have been purged. Refilled them(except HS ) with 60psi nitrogen for module silo storage before next year using.

  1160   Wednesday, March 02, 2016, 09:51 David WangITWStandard OperationTM2 all water lines on TM2 and TM4 are purged.

All water lines on TM2 and TM4 are purged for upcoming water lines helium pressure test.

  2748   Tuesday, January 14, 2025, 10:00 David WangSouth Hot-CellStandard OperationTM3UCx#47after operation electrical check, Tm3 UCx 47

TM3 UCx#47 after operation electrical check  is done at SHC. The result is normal. See attachment.

Attachment 1: TM3_UCX_47_after_operation_electrical_check.pdf
TM3_UCX_47_after_operation_electrical_check.pdf
  1994   Tuesday, October 01, 2019, 10:22 chad fisherSouth Hot-CellStandard OperationTM2ZrC#8ZrC#8 Removed Ta#59 installed

ZrC#8 has been removed from TM2. Upon removal of the high current tube heater bolts it was noticed that the tube was broken. Also the 9 pin connector has an arc mark (see pictures attached).

Ta#59 has been installed with new fasteners. High current fasteners torqued to 130 in lbs.

Attachment 1: 20190930_140918[1].jpg
  1997   Wednesday, October 02, 2019, 08:25 chad fisherSouth Hot-CellStandard Operation ZrC#8ZrC#8 PIE

Heat shield has been removed from ZrC#8.

Attachment 1: 20191002_081653[1].jpg
  1101   Wednesday, October 14, 2015, 14:03 chad fisherSouth Hot-CellStandard OperationTM2ZrC#7ZrC#7 removed

ZrC#7 has been removed from TM2. Everything looks good.

Attachment 1: 20151014_134022.jpg
Attachment 2: 20151014_135127.jpg
  1113   Friday, October 23, 2015, 11:30 chad fisherSouth Hot-CellStandard Operation ZrC#7ZrC#7 Spent Move and Febiad Coil

ZrC#7 was transfered to a spent target disposal pail today and removed from the hot cell. The "hot" end of the TM4 coil end was also disposed of in the same pail (#129)

  2552   Thursday, March 21, 2024, 11:35 Ferran Boix PamiesITEDevelopment  Wiring of new thermocouple PLC module

 Thursday, March 21, 2024, 11:33 Three channels are available now for thermocouple readouts from the Target multipin. Wiring from the PLC modules to the connection terminal blocks and labeling done.
