Logbooks Lab Maintenance Evaporator_1 Evaporator_2 Laser cutter Target Production Test-Stand RH-ISAC RH-Cyclotron RH-Meson Hall RH-Beamlines RH-ARIEL
  RH-ISAC, Page 59 of 140  Not logged in ELOG logo
ID Date Author Category Type Moduledown Target/Number Subject
  893   Tuesday, April 21, 2015, 13:01 Grant MinorITWDevelopmentTM2 TM2 MK4 Optics Tray - banana plug bore modification (on bench)

The MK4 optics tray prepared for TM2 (as per ITA6082) had an undersized bore for the banana plug, making insertion of the plug extremely difficult / impossible.

Reference stores parts were collected to check the fit:  male plug 3-4/01152 and female jack 1-6/1201.  The size of the female jack was checked with a #21 drill at .159".

The bore on the optics tray was drilled out dry using the #21 drill to the same depth as the original blind hole, by Maico and Dan McDonald.  Chips were carefully collected in a rag, and the hole was blown out with compressed air.

The fit was checked to be snug but possible, using the male plug and the Remote Handling ultem base (ref ITA6023).

Redlines and photos are attached.



Attachment 1: ita6092_redlines_gminor_21apr2015.pdf
ita6092_redlines_gminor_21apr2015.pdf
Attachment 2: TM2_Optics_Tray_Bore_Mod_21Apr2015_1.JPG
Attachment 3: TM2_Optics_Tray_Bore_Mod_21Apr2015_2.JPG
Attachment 4: TM2_Optics_Tray_Bore_Mod_21Apr2015_3.JPG
  899   Monday, April 27, 2015, 16:12 Keith C NgSouth Hot-CellDevelopmentTM2 Ceramic Standoffs in TM2 source tray steerer assembly

On drawing ITA6008 for the Encole 0.5" ceramic standoffs there is a note to match pairs of ceramics to within +/-0.001". This step was missed on the current build of TM2 source tray (ceramics were not measured).

Measured the lengths of the rest of the ceramic standoffs in inventory and they range from 0.5035" to 0.4950" in length. The ceramics have been sorted by length and grouped into bags.


  900   Monday, April 27, 2015, 17:09 Grant MinorITEDevelopmentTM2 TM2 - New Source Tray - Water Block Seal Groove Inspection Report

The water blocks soldered to the TM2 cooling lines (see Ref. Assy. ITA6144) were inspected.

See attached inspection reports and drawings.

It was found that only 18% of the seal groove diameters and 55% of the depths were in spec.

The source tray must be tested on the test stand with c-seals to ensure that these blocks will seal properly on the module.

Attachment 1: IMG_1859.JPG

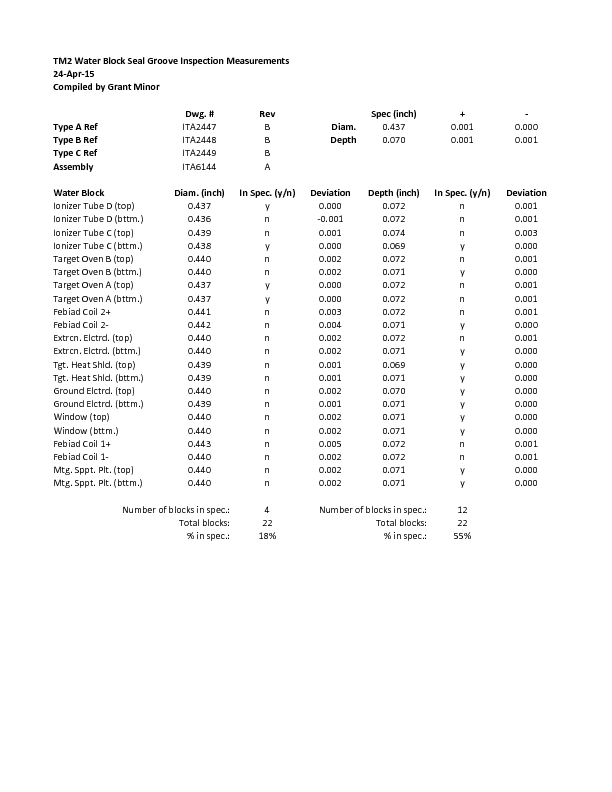

Attachment 2: TM2_New_Source_Tray_Water_Block_Inspection_Results_24_April_2015.pdf
TM2_New_Source_Tray_Water_Block_Inspection_Results_24_April_2015.pdf
Attachment 3: TM2_water_block_inspect_24Apr2015.pdf
TM2_water_block_inspect_24Apr2015.pdf TM2_water_block_inspect_24Apr2015.pdf TM2_water_block_inspect_24Apr2015.pdf TM2_water_block_inspect_24Apr2015.pdf
Attachment 4: TM2_New_Source_Tray_Water_Block_Inspection_Results_April_2015.xlsx
  906   Thursday, April 30, 2015, 08:50 Travis CaveSouth Hot-CellStandard OperationTM2No targetModule move

TM#2 with no source tray has been moved from the north east silo to the south hot cell.

  907   Friday, May 01, 2015, 08:27 chad fisherSouth Hot-CellRepairTM2 Containment Box Removal

Containment box has been removed in preparation for wire replacement.

  908   Friday, May 01, 2015, 13:48 David WangSouth Hot-CellStandard OperationTM2 Target Hall Scheduled Activities April 07 - June 26 2015 update

Target Hall Scheduled Activities  April 07 - June 26  2015 update.      2015-05-01. All TH scheduled jobs are finished on time this week.

Attachment 1: Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.mpp
Attachment 2: Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf
Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf
  910   Tuesday, May 05, 2015, 10:57 chad fisherSouth Hot-CellRepairTM2 TM2 Wiring

Old wiring was removed yesterday, new wiring run thru the vacuum chase. Old IMG gauge removed today, new cable trays installed and wires installed into cable trays.

Attachment 1: TM2_New_Wiring_20150504_13.jpg
Attachment 2: TM2_Wiring_20150505_10.jpg
  911   Wednesday, May 06, 2015, 14:30 Travis CaveSouth Hot-CellRepairTM2No targetWiring of TM#2

Wires for TM#2 steering elements, and png gauge have been run down to the containment box level. Chad has placed them in the little cable trays. Slack has been pulled back. and termination of the wire will be done on the 7th of May. A modification was done to the signal line of the png gauge wire ultem block, as grounded screw was inserted to allow for strain relief so the end would hopefully quit breaking. See attached pictures for the details.

Attachment 1: Photo_2015-05-06_8_26_10_AM.JPG
Attachment 2: Photo_2015-05-06_8_26_17_AM.JPG
  912   Thursday, May 07, 2015, 11:02 Travis CaveSouth Hot-CellRepairTM2No targetWiring of TM#2

Wires in TM#2 have been terminated at the top of the module.

  914   Monday, May 11, 2015, 11:20 David WangSouth Hot-CellStandard OperationTM2 Target Hall Scheduled Activities April 07 - June 26 2015

The schedule has some changes due to  new TM2 source tray coil cooling line leaking at test stand. Now,It is re-scheduled in such an estimation  that TM2 source tray could be ready at teat stand by this Friday(May-15th). see attachment 1,2.

2015-05-12,  Changed  and updated the TH activity schedule according to Dons new beam schedule which is re-arranged after the coil line leaking issue. See attachments 3,4. No major conflicts has been found on the new schedule.

2015-05 25, Updated the TH activity schedule according to present TM2 job processing. See attachment 5,6.

Attachment 1: Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.mpp
Attachment 2: Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf
Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf
Attachment 3: Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.mpp
Attachment 4: Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf
Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf
Attachment 5: Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf
Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.pdf
Attachment 6: Target_Hall_Scheduled_Activities__Apr_07_to_June_26_2015.mpp
  915   Wednesday, May 13, 2015, 13:55 chad fisherSouth Hot-CellRepairTM2 Shutter removal

TM2 has been successfully de-shuttered.

All went pretty much according to plan except I had to remove one fastener out of the upper wiring harness (the one that has just been installed) to allow for enough clearance to rotated the shutter guide out of the way...I shutter to think what would have happened otherwise...anyways...

Close inspection of the shutter does show that the "thin" area isn't in very good shape; whether this is a result of removal or just the way it was is hard.Due to the ease of removal I would quess that it may have been a preexisting condition. That being said...I think we may want to consider replacing it.



Attachment 1: TM2_20150513_131339.jpg
Attachment 2: TM2_20150513_134232.jpg
  917   Tuesday, May 26, 2015, 11:49 Grant MinorAssembly/Bench TestRepairTM2 TM2 New Source Tray - Braze & Solder Report - 22 May 2015

Hello,

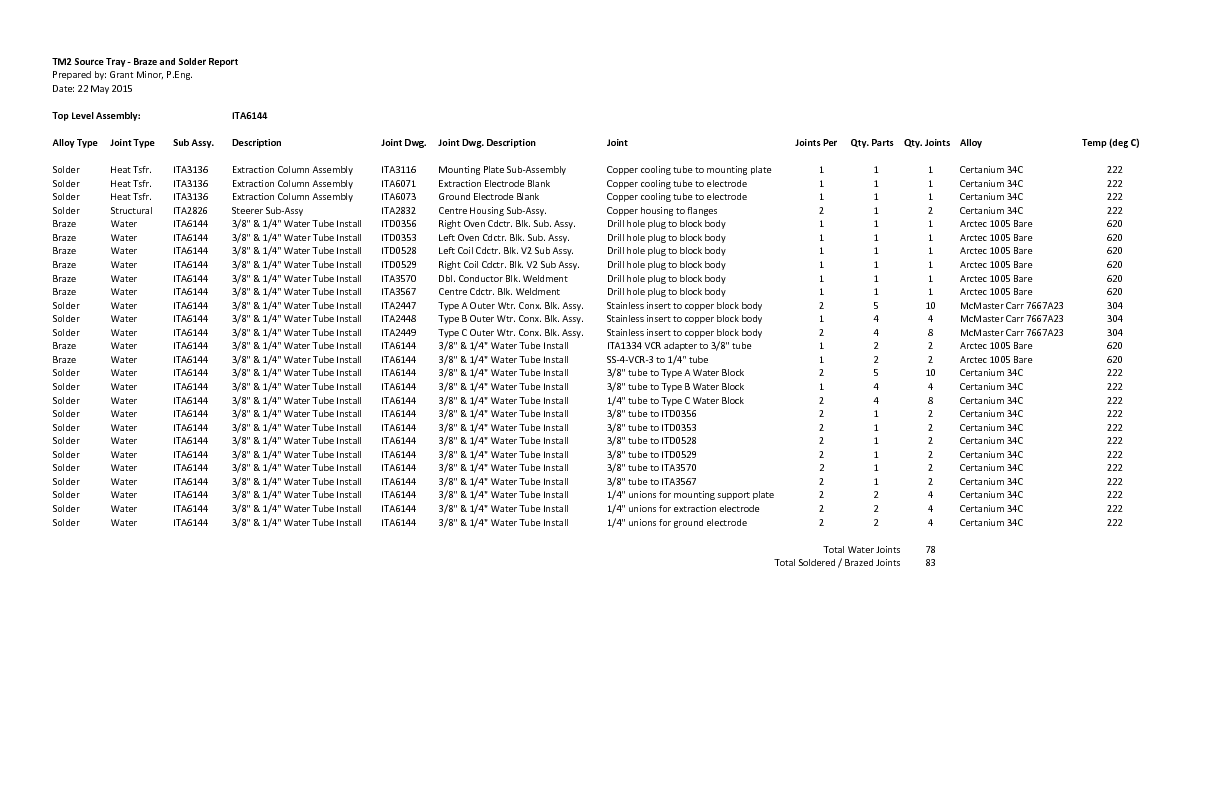

For reference, I have attached a list of all solder joints in the TM2 Source Tray, and the alloys used for the most recent build (as per ITA6144).   I have also provided data sheets for the alloys, and PDF copies of all the drawings calling out the joints.

Certanium 34 C (222 deg C melt point) was used for all low-temperature solder applications, except for the steel inserts in the water blocks.  Previous revisions of the Source Tray drawings called out a higher-temperature McMaster lead-based solder (304 deg C melt point).  The change to Certanium 34 C on the prints was made in Bevan's era, during the transitional update of the source tray drawings between the TM1 and TM3 source tray projects, just before I took over updating the drawing packages.  I believe Bevan made this change on general advice from Guy Stanford, who stated that Certanium 34 C is a much easier solder to work with and makes a more mechanically reliable joint.  However, the change really should have had more review and validation testing before being implemented.

This said, we now have a source tray that uses Certanium 34 C, and rework of every joint would set us back too far in the schedule to meet the deadline, so we will have to run with it as it is.

Of particular concern are the joints on the target oven and coil heating blocks, which are now using a lower temperature solder (222 deg C melt vs 304 deg C melt).  We have experienced a coil block failure on TM4 due to a failed solder joint, although the failure mode is not known for certain.  We also had two recent failures on the test stand of a coil joint soldered with Certanium 34 C, but this was due to an error in the connection of cooling water to the joints (i.e. the joints had no coolant flow and the solder melted... this is expected!).

Anders and I have performed independent thermal analysis on the joints due to the radiative and electric heating from the target, and have concluded that even with a lower temperature solder, there is a lot of margin, so the risk seems to be low.  This work will be published in a separate report to be circulated later.

Thank you and regards,

Grant

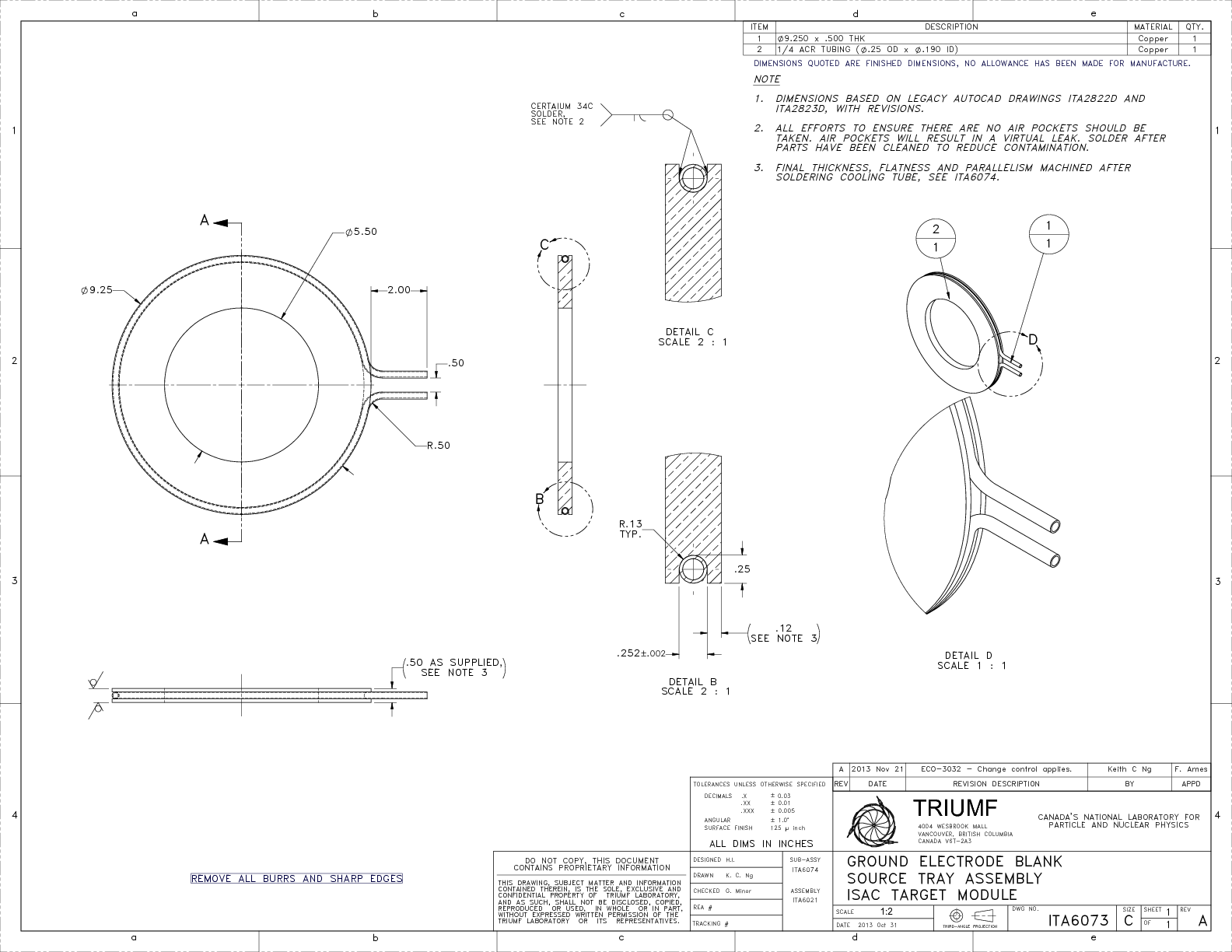

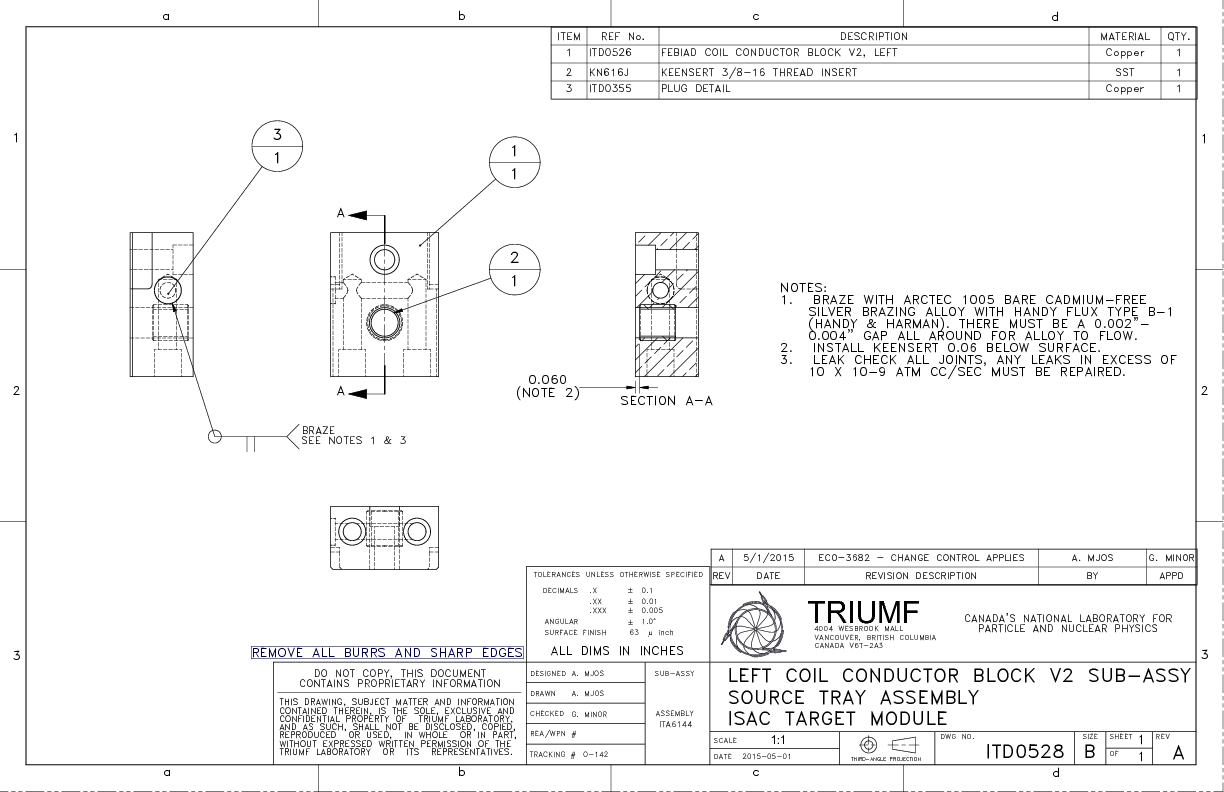

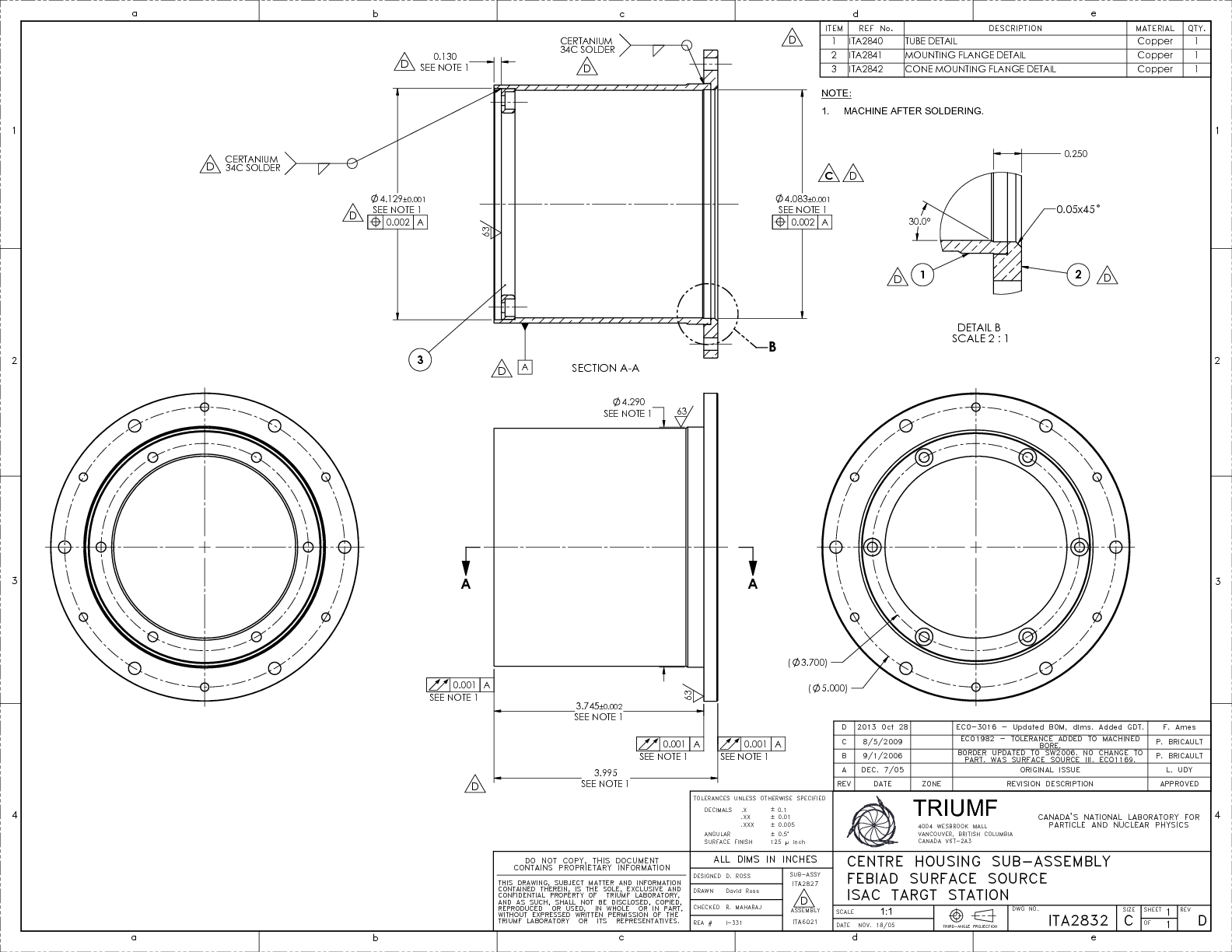

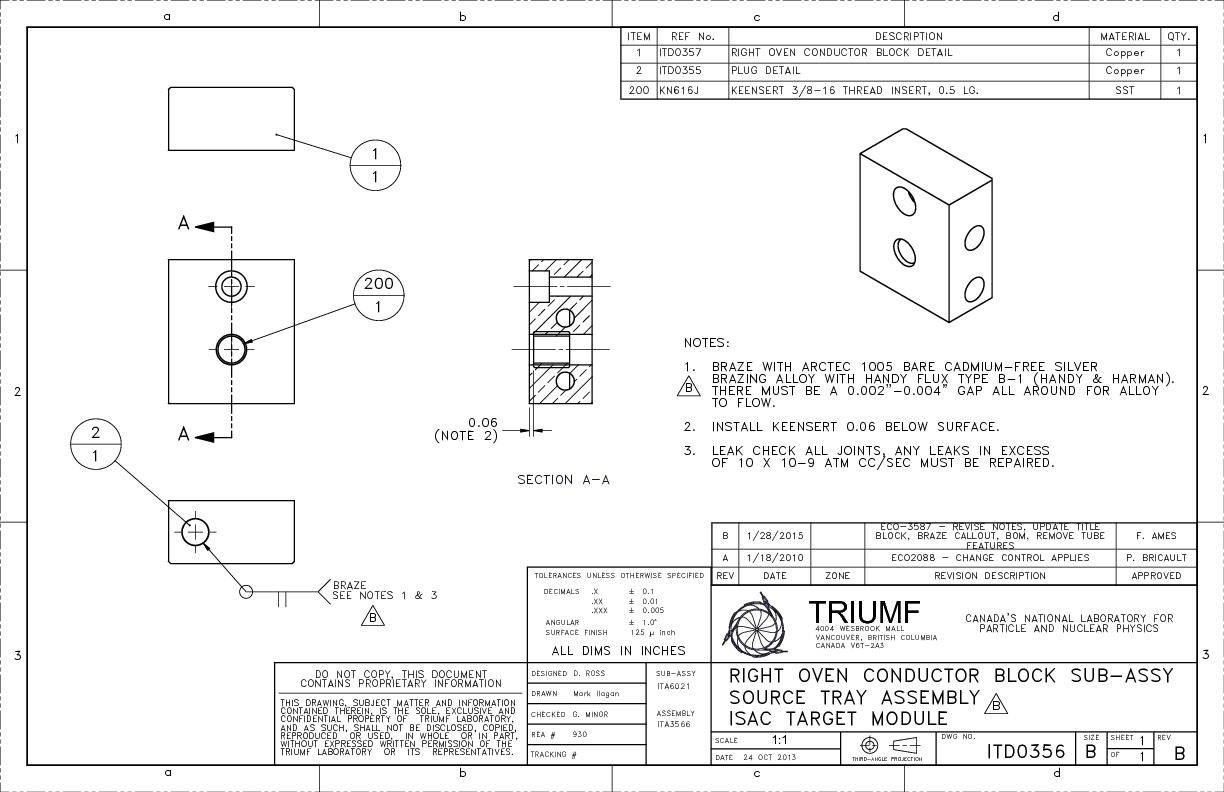

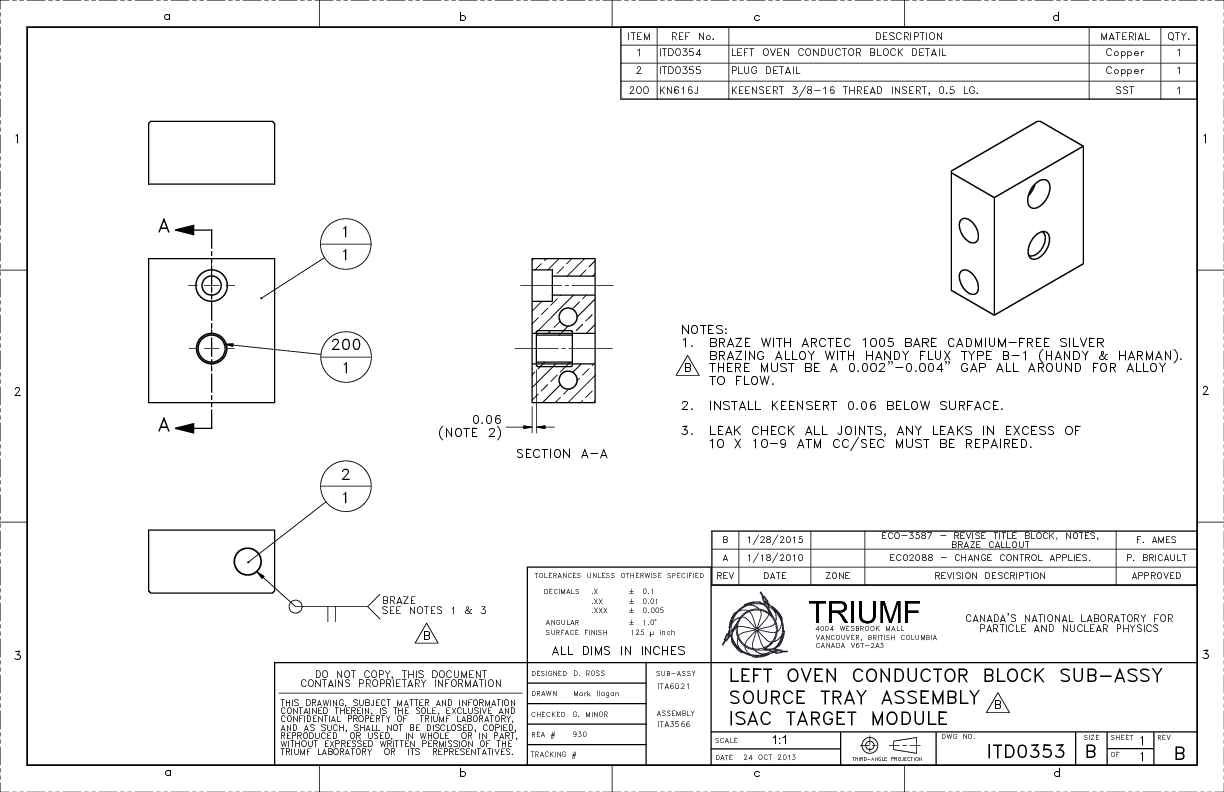

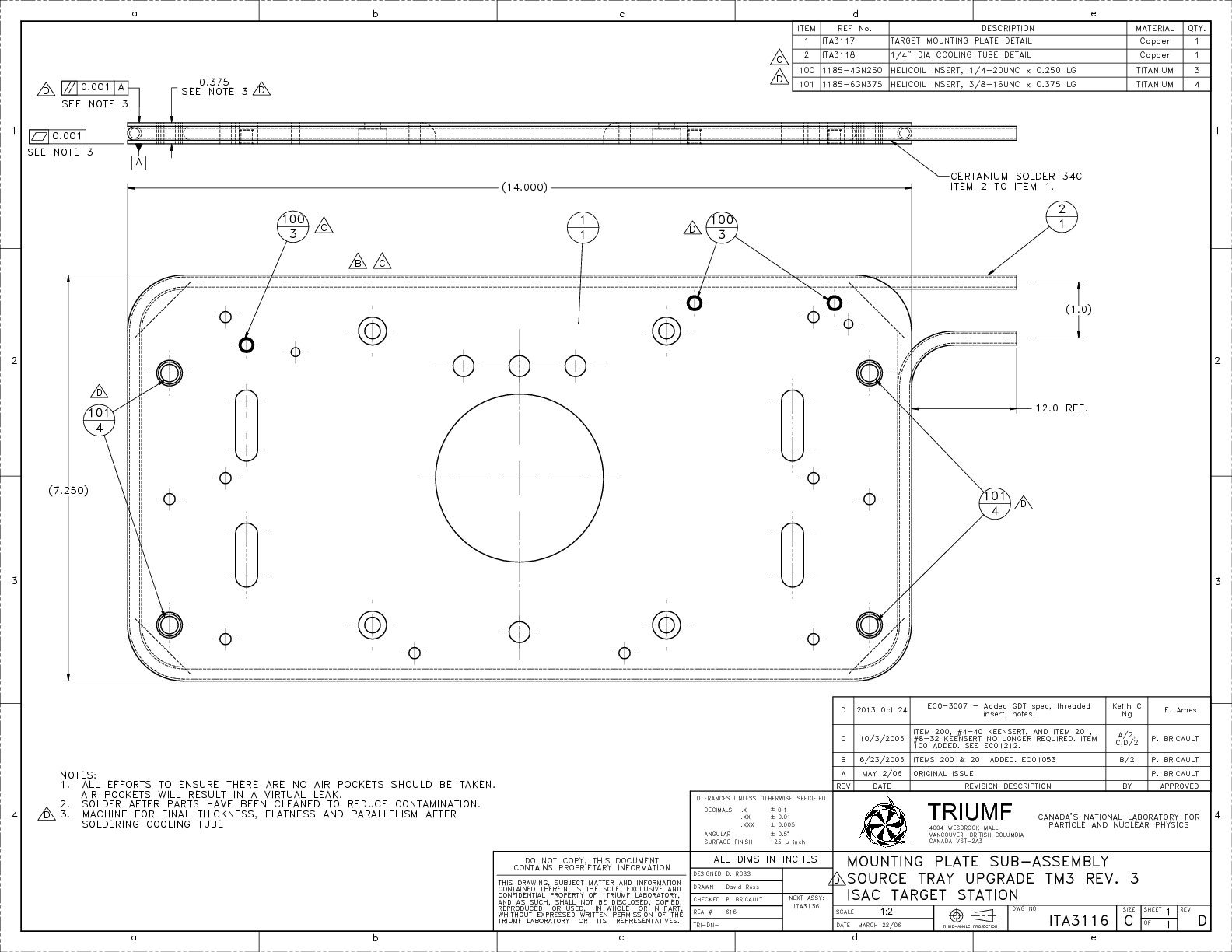

Attachment 1: TM2_Source_Tray_-_Braze_and_Solder_Report_File_-_22May2015.pdf
TM2_Source_Tray_-_Braze_and_Solder_Report_File_-_22May2015.pdf TM2_Source_Tray_-_Braze_and_Solder_Report_File_-_22May2015.pdf TM2_Source_Tray_-_Braze_and_Solder_Report_File_-_22May2015.pdf TM2_Source_Tray_-_Braze_and_Solder_Report_File_-_22May2015.pdf TM2_Source_Tray_-_Braze_and_Solder_Report_File_-_22May2015.pdf TM2_Source_Tray_-_Braze_and_Solder_Report_File_-_22May2015.pdf TM2_Source_Tray_-_Braze_and_Solder_Report_File_-_22May2015.pdf TM2_Source_Tray_-_Braze_and_Solder_Report_File_-_22May2015.pdf
Attachment 2: 1005_Bare_DS.pdf
1005_Bare_DS.pdf
Attachment 3: 1005_Bare_MSDS.pdf
1005_Bare_MSDS.pdf 1005_Bare_MSDS.pdf 1005_Bare_MSDS.pdf 1005_Bare_MSDS.pdf
Attachment 4: Certanium_34C_Data_Sheet.pdf
Certanium_34C_Data_Sheet.pdf Certanium_34C_Data_Sheet.pdf
Attachment 5: Certanium_34C_MSDS.pdf
Certanium_34C_MSDS.pdf Certanium_34C_MSDS.pdf Certanium_34C_MSDS.pdf Certanium_34C_MSDS.pdf Certanium_34C_MSDS.pdf Certanium_34C_MSDS.pdf
Attachment 6: mcmaster_carr_solder_7667A23.pdf
mcmaster_carr_solder_7667A23.pdf
  918   Tuesday, May 26, 2015, 14:34 chad fisherSouth Hot-CellRepairTM2 Shutter replacement

The shutter in TM2 was successfully replaced today.

New lock washer and nut were installed onto shutter and nut torqued to 120 ft lbs.

Shutter guide alignment tool was used to insure tapped shutter guide holes were concentric with thru holes in shutter side mounting panel, button head screws replaced and torqued to 110 ft-lbs.

The shutter was manually cycled open and closed by David and everything is to operate well.

Attachment 1: Shutter.jpg
  919   Wednesday, May 27, 2015, 08:57 Travis CaveConditioning StationStandard OperationTM2 Module moved

TM#2 with no source tray has been moved from the south hot cell to the conditioning station.

  920   Friday, May 29, 2015, 09:16 Travis CaveConditioning StationStandard OperationTM2no targetModule moved

TM#2 with no source tray has been moved from the conditioning station to the north east silo.

  933   Thursday, June 04, 2015, 07:44 Dan McDonaldAssembly/Bench TestDevelopmentTM2 Movement of TM2 source tray to alignment area in ISAC

Once the test stand was vented and all lines purged Anders Mjos and myself jigged up the water blocks and proceeded to remove the TM4 SiC#31 target used during the testing, Einso lens and steerer.  Once these components where removed we transferred the source tray to the transport plate and moved it to the alignment area.

  934   Thursday, June 04, 2015, 08:27 chad fisherAssembly/Bench TestRepairTM2 TM2 Source Tray C-seal removal and inspection

Source tray for TM2 has been moved to the alignment area by Dan and co.

This morning Dan removed the c-seals used during the test and he and I inspected the sealing surfaces to determine if they need to be cleaned...they do..trace indium was present on all blocks.

Surfaces will be cleaned before final alignment check.



Attachment 1: TM2_20150604_01.jpg
Attachment 2: TM2_20150604_02.jpg
Attachment 3: TM2_20150604_03.jpg
Attachment 4: TM2_20150604_04.jpg
Attachment 5: TM2_20150604_05.jpg
  935   Monday, June 08, 2015, 14:40 chad fisherAssembly/Bench TestRepairTM2 TM2 Source Tray Final Alignment Check

Final Alignment checks of the TM2 source tray took place today.

Mater Jig: Front - 0,0 Back - 0 left, right, .005 low

Tray: Front .001 High, .001 right Back - .001 right, .008 low

Which equals  Tray: front .001 high, .001 right back: .001 right, .003 low in comparison to the master jig which is both within spec and within reason to pre-soldering numbers.

Steerer was out significantly and currently sits at .003 high, .002 right wrt. master jig.

More refinement on the steerer tomorrow and check on the optics tray as well.

  936   Tuesday, June 09, 2015, 09:49 chad fisherAssembly/Bench TestRepairTM2 TM2 Source Tray Final Alignment Check

Final alignment continued this morning.

Steerers have been aligned to 0.001 low, 0.000 left/right wrt master jig.

Optics tray required some adjustment as well and is now at:

Front 0.000 left/right, .001 high wrt master jig

Back 0.001 high, 0.000 left/right wrt master jig

Febiad coil conductor blocks have been reset with the master target jig as well...as they have been on and off during the test stand test.

A few components have been removed during the test stand test (such as feet required for tranfser jig) which I will now hunt down.

Otherwise i believe we are ready.

  937   Tuesday, June 09, 2015, 14:36 chad fisherAssembly/Bench TestRepairTM2 TM2 Source Tray Final Inspection

Final inspection took place with Pierre, Grant, Friedhelm and Anders present.

Two action items were raised:

1) check routing of 9 pin connector line

2) Check orientation of 9 pin water block

Chad pointed out concerns on clearances between a target and conductor block waterlines, possible optics tray alignment issues (that it had changed slightly from the initial alignment), and gap between steerer housing and ground electrode due to alignment.

Attachment 1: 20150609_132818.jpg
Attachment 2: 20150609_132825.jpg
Attachment 3: 20150609_132833.jpg
Attachment 4: 20150609_132839.jpg
Attachment 5: 20150609_132851.jpg
ELOG V2.9.2-2455
